UPDATE
June 10
On Sunday, June 7, a large crowd of approx. 300 people gathered at the Chabad Center for a dedication ceremony of the new Chabad Educational Center.
To see pictures of the event, CLICK HERE
Since the opening of the Early Learning Center and David Hoffman Hebrew School at the new facility in September, we made much progress in the completion stages of the construction.
In January 2009, right after Chanukah, the Chabad Center offices relocated to the new building. In April we completed the construction of the Mikvah, had it inspected by the authorising Rabbi, and then started the process of filling the Mikvah with rain water. A special Mikvah inauguration program is scheduled for July 13, although the Mikvah is now ready and operational.
After the filling of the main Mikvah, we filled the Keli Mikvah (vessel Mikvah), which has been in use since Passover.
To see pictures of the completed Mikvah, CLICK HERE

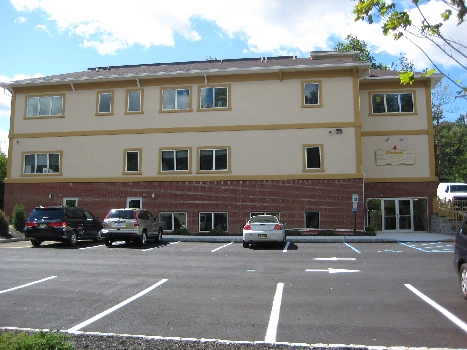

The CHABAD EDUCATIONAL CENTER is now open and fully operational.
If you would like to schedule a tour of the facility,
please contact Rabbi Baumgarten, 973 625-1525 Ext. 202
Your generous support is greatly needed and appreciated.
To become a partner and help assure the realization of this dream,
and to sponsor a dedication in honor or in memory of a loved one,
please call Rabbi Herson: 973 625-1525 Ext. 227, or E-Mail
September 15
On Wednesday, September 5, The Chabad Educational Center opened its doors with the start of the new school year for the Chabad Early Learning Center and the David Hoffman Hebrew School and Chabad Hebrew High!
After passing the elevator inspection, we received our temporary certificate of occupancy (the final c.o. will come with the completion of the Mikvah in the very near future). The final work i.e. moving cleaning and preparing the classrooms, took place at a feverish pace so we could open our doors.

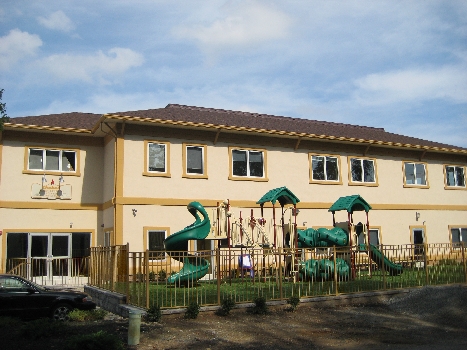

The playground is complete.
The classrooms are set up and in action.
The indoor fitness room for the Early Learning Center to be complete this week.
The hallways are filled with the laughter and cheers of excited children, enthusiastic teachers and ecstatic parents.
The lower level is also progressing at a fine pace.
The carpets have been installed.
The furniture is on order.
We anticipate moving our weekday minyan, main offices, Adult Education classes to the new location in the coming weeks.
Stay tuned for details on the Mikvah which is also nearing completion.
For pictures, CLICK HERE
August 17

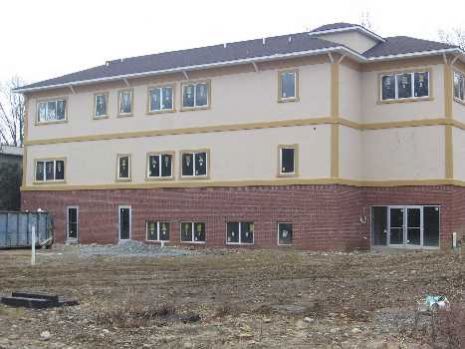

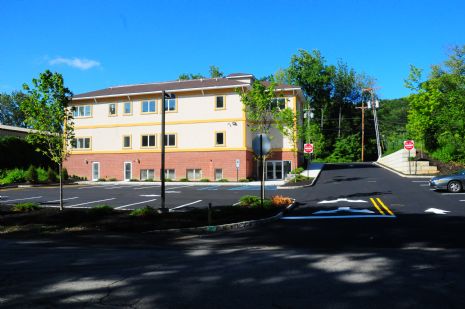

The upper two floors (Early Learning Center & David Hoffman Hebrew School) are complete.
The flooring and mill work are done. We have gone through several inspections and should have the temporary C.O. early this week.
The parking lot and driveway is complete with all the line painting and signs etc.
The fence around the play area (on the Pawnee Ave. side of the building) is being put up this week, followed by the playground next week.
The downstairs (offices, library / sanctuary) are almost done and will be ready for carpet in the coming week.
The tiling, plumbing and electrical work in the Mikvah is complete and painting should resume in the coming weeks. in the Mikvah is complete.
For pictures of the progress, CLICK HERE
June 24
The upper two floors which will serve the Chabad Early Learning Center, the David Hoffman Hebrew School and the Hebrew High is ready for flooring which will commence at the beginning of the week.
As you will see in the pictures, the vanities, sinks and bathroom appliances have all been installed. The kitchen cabinets and storage closets for the Early Learning Center are in place.
The Lower level which will serve as the Library, week-day Synagogue, adult education institute, main offices and rabbi's offices are nearing completion.
We are scheduled for for elevator inspection in the coming weeks.
The side walks and curbing are complete. The asphalt is more then half way complete and will be done by the end of the week.
The telephone lines for the elevator and burglar and fire alarms have been installed. The computer and phone system will follow in the coming weeks.
For pictures of the progress, CLICK HERE
May 1
The tiling of the two main floors is complete. The tiling of the Mikvah and lower level is being worked on at a feverish pace.
The building has been painted.
The drop ceilings are installed.
HVAC and electrical fixtures are all installed and passed inspection on the two main floors.
The doors have been hung and leveled.
cabinetry and decorative touches are already underway, and the flooring will begin in just over a week.
The curbing of the parking lot and outdoors is complete, and the pavers are currently being laid followed by the asphalt in approx. 2 weeks.
For pictures of the progress, CLICK HERE
March 13
The sheet rock has been installed.
The building has been spackled and sanded.
The building has been primed, and the painting has already begun on the window sills and trims.
The grids have been installed for the drop ceilings.
The electric and HVAC is almost complete in the drop ceilings enabling us to soon put in the ceiling tiles.
The door jams have been installed, some of the doors have been hung, and the rest will follow in the coming weeks.
The tiles in the classrooms and school bathrooms have been installed. The tiles for the main lobby will be installed on Monday.
MIKVAH UPDATE:
The HVAC, electric, alarm & audio are complete.
The framing of the Mikvah is complete.
Sheet-rocking of the Mikvah will begin on Tuesday.
The Mikvah tiles have been delivered.
Our Mikvah consultant, Rabbi Grossbaum of MN, was at the site for several hours last week, and gave his approval to the progress of the Halachik aspects of the Mikvah, i.e. the gutters and leaders to bring the water into the Mikvah, and the system for the Keli (dishes) Mikvah.
We anticipate the work on the Chabad Educational Center to continue at a feverish pace!
For pictures of the progress, CLICK HERE
January 25

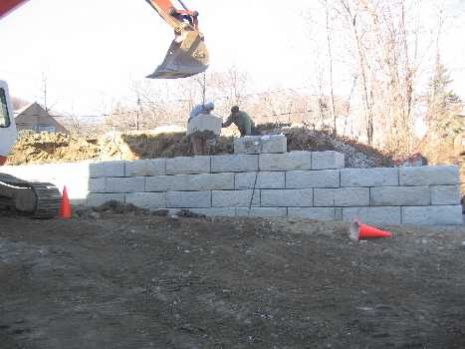

The retaining wall was built and completed this week.
The sheet rock was delivered on Monday.
The sheet rock on the third floor is almost complete, and the second floor is well underway. The sheet rock should be completed by the middle of the week, to be immediately followed by spackling and painting.
The tiles for the Mikvah will be delivered and installed shortly.
For pictures of the progress CLICK HERE
January 17
The electrical work is complete and inspection passed.
The plumbing work and roughings is complete and inspection passed.
The framing is complete and inspection passed.
The insulation is complete and inspection passed.
The duct work is complete.
The sprinkler system is complete.
All wiring for security systems, fire alarm, access control, computer and telephone network is installed.
The elevator is installed.
The bath tub and whirlpool tub are installed in the Mikvah.
Sheetrock installation is beginning Monday morning.
Excavation for the exterior retaining wall and asphalt is underway.
For pictures of the progress CLICK HERE
October 17
The exterior doors are in.
The electric has been connected to the building (after a lengthy wait for new poles for the electric company).
The water pipes have been run into the building for the water supply and sprinkler systems.
The drainage pipes for the roof drains and gutters have been laid.
The duct work is nearing completion.
The electric wiring of the building is almost complete.

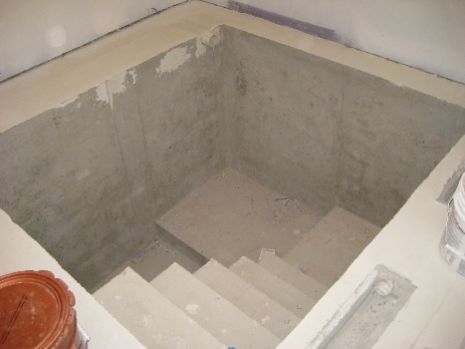

The Keli Mikvah - Dishes Mikvah has been poured and is almost done.
The Mikvah steps have been poured and the mikvah is almost ready for tiling.
The sprinkler system is near completion.
In the coming week, the wiring for the burglar alarm, fire alarm, computer and phone systems etc will commence.
For pictures of the progress, CLICK HERE.
August 10
The stucco is complete.
The framing for the exterior doors is done.
The electric and plumbing is continuing at a steady pace.
The HVAC Units have been installed, and the duct work is currently underway.

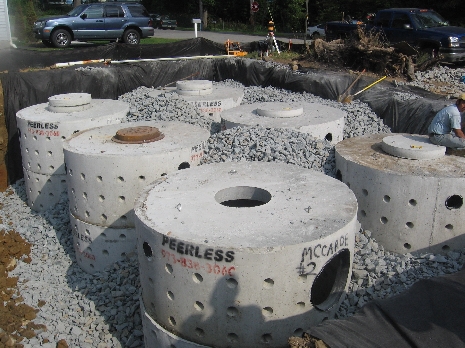

The forms for the Keli Mikvah - Dishes Mikvah have been set, and the concrete will be poured in the coming days.
The elevator work has begun this week.
For pictures of the progress, CLICK HERE
July 4
The stucco work is well underway, and work on the color will begin in the coming days.
Ceiling insulation, soundproofing and sheet rock is complete.
The electrical work is well underway, with the main panels installed as well as most of the outlet boxes and light switch boxes.
The steps for the building have been delivered and will be installed in the coming days.
The doors, HVAC units, sprinkler system and elevator are going to be delivered in the coming days.
For pictures of the progress, CLICK HERE.
June 13
The indoor framing is done.
We passed our second phase plumbing inspection.
Ceiling insulation and soundproofing is currently underway.
The exterior brick work is complete.
The following work is about to begin: Electric, sprinkler system, doors, stucco, HVAC and more.
For pictures of the progress, CLICK HERE.
May 30
The slab is in.
The plumbing is progressing at an aggressive pace.
The exterior brick work is almost complete.
The Stucco will follow shortly.
For pictures of the progress, CLICK HERE
May 1, 2007
The soundproofing and flooring is just about complete.
The ground floor and Mikvah plumbing is almost complete and ready for inspection.
The waterproofing and soundproofing is done.
The elevator shaft is done as well as the masonry for the second stairwell.
The framing of the two upper floors is almost complete.
In the coming days...
Pouring of the slab.
Exterior brick work and stucco.
Electrical work.
Preparation for pouring the "dishes mikvah".
Framing of the offices and library.
For pictures of the progress, CLICK HERE
April 18, 2007
The windows are in.
The soundproofing and flooring are currently being installed.
The roof drains are in, and the plumbing work has begun.
The waterproofing will commence within a few days, as well as the laying of the blocks for the stairwell and elevator shaft.
The inside framing and electrical to follow shortly.
For pictures of the progress, CLICK HERE
March 27, 2007
The outside framing is complete.
The main part of the roof is done.
The plumbing work has begun.
The windows are on the way in the coming days.
Inside framing, electrical work and sprinklers to be done shortly... For pictures of the progress,CLICK HERE
March 8, 2007

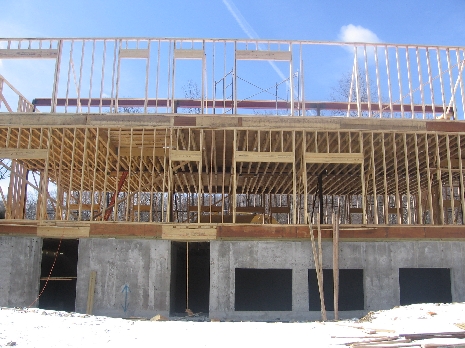

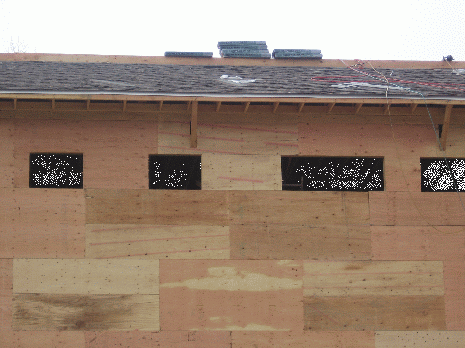

The framing is well under way.
Work is about to begin on:
Roofing Drains, Roof, Electric, Plumbing and Sprinkler System...
For pictures of the progress, CLICK HERE
February 6, 2007
Columns and Girders have been installed.
The exterior has been covered in pitch.
They have started the backfill.
The framers are on the way...
For pictures of the progress, CLICK HERE
January 25, 2007

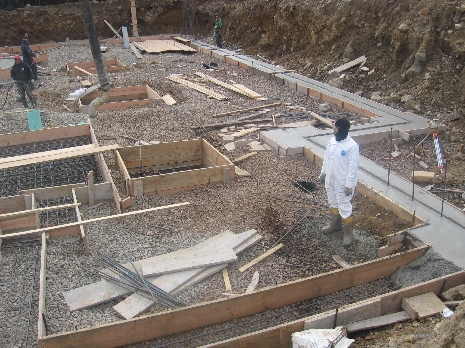

The walls for the lower level of the building were poured.
Some of the Mikvah plumbing was done, in the forms for the Mikvah.
The Mikvah was poured under the guidance of our expert Mikvah consultant, Rabbi Gershon Grossbaum of St. Paul MN.
The forms have been removed.
The outside walls have been covered in pitch.
Work has begun on the steel columns for the structure.
For pictures of the progress, CLICK HERE
January 12, 2007
The Foundations have been poured.
The forms for the walls are up.
On Thursday, January 11 we passed inspection.
This Tuesday, January 16, we will pour the concrete for our Community Mikvah and the walls of the first floor of the Chabad Educational Center.
For pictures of the progress, CLICK HERE
December 13, 2006
The past few weeks have brought significant progress to the construction.
A concrete base was created for the Mikvah (The actual Mikvah will be poured shortly). The masons got to work in making the frames for the forms and foundations. The foundation was finally poured this week. To see pictures of the progress, CLICK HERE
October 27, 2006 -

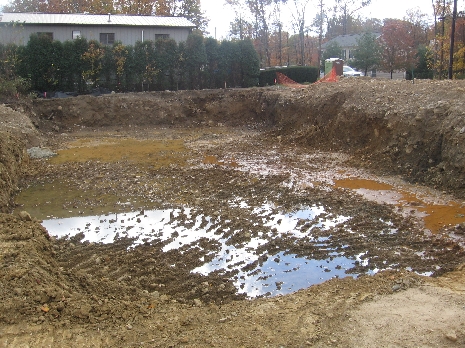

Digging for the foundation is almost complete.
The pouring of the foundation will G‑d willing take place in the near future.
October 3 - 17, 2006 -
The drainage system is almost complete.
The property is staked out for the foundations.
Consultations underway with potential Masons.
Consultation underway with our Mikvah expert, Rabbi Gershon Grossbaum of Minnesota.
Digging is now underway for the laying of the foundation.
CLICK HERE for more pictures
Monday, September 18, 2006 -
Site Work Continues
Construction continues with the site work.
Installation on the drainage system is now underway.
CLICK HEREfor pictures.
Tuesday, March 7, 2006 -
Dawn of A New Day of Development

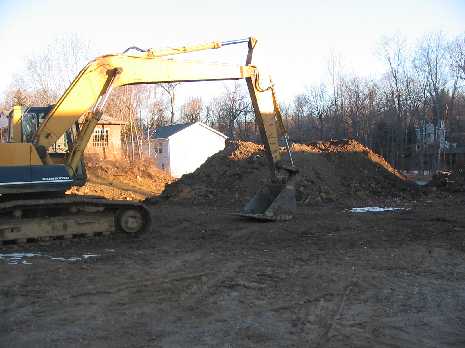

Excavation is Under Way!!
CLICK HERE for Pictures
Sunday, November 13 - In the presence of over 200 people, the groundbreaking ceremony took place for the new building. We now anticipate the beginning of the construction.
Stay tuned for all the developments.
